Lemon Grove’s Rules for Walls, Section by Section

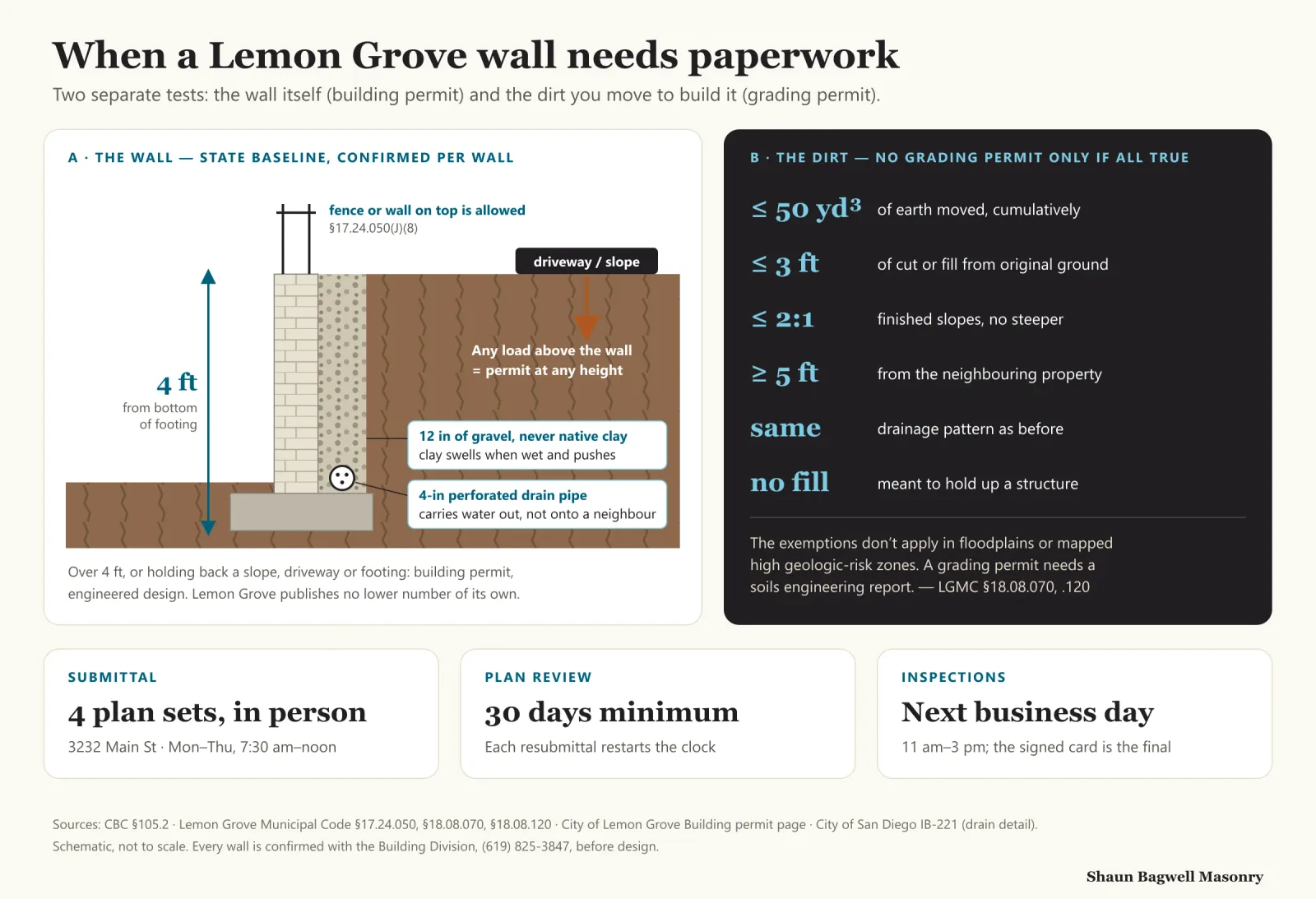

The wall. Lemon Grove doesn’t publish a retaining-wall permit height of its own, so the state baseline applies: a wall up to 4 feet measured from the bottom of the footing that holds back no slope, driveway or building load is exempt; anything taller or loaded needs a permit and, in practice, an engineer. That’s more generous than the City of San Diego next door, which starts at 3 feet from the top of the footing — so don’t assume a contractor’s San Diego habits apply here, or the reverse. We confirm each wall with the Building Division at (619) 825-3847.
The dirt. The grading exemption in §18.08.070 only works if every condition holds — and it never applies in a floodplain or a mapped high geologic-risk area, which in Lemon Grove means paying attention around Federal Boulevard. A grading permit needs three copies of a preliminary soils engineering report.
The paperwork. Submittals are in person at City Hall, 3232 Main Street, Monday to Thursday from 7:30 a.m. to noon, with four full-size plan sets. Each review takes at least 30 days, and a resubmittal restarts the clock. Inspections are usually the next business day, between 11 a.m. and 3 p.m., and the signed inspection card is the final.
